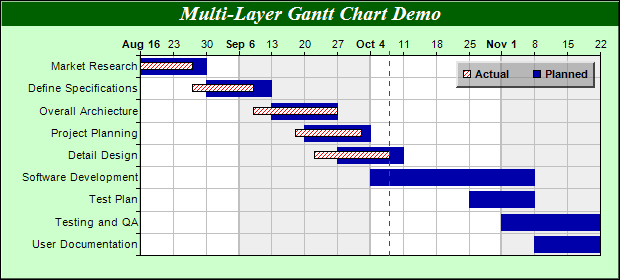

[File: phpdemo/layergantt.php]
<?php
require_once("../lib/phpchartdir.php");
# the names of the tasks
$labels = array("Market Research", "Define Specifications", "Overall Archiecture",
"Project Planning", "Detail Design", "Software Development", "Test Plan", "Testing and QA",
"User Documentation");
# the planned start dates and end dates for the tasks
$startDate = array(chartTime(2004, 8, 16), chartTime(2004, 8, 30), chartTime(2004, 9, 13),
chartTime(2004, 9, 20), chartTime(2004, 9, 27), chartTime(2004, 10, 4), chartTime(2004, 10, 25),
chartTime(2004, 11, 1), chartTime(2004, 11, 8));
$endDate = array(chartTime(2004, 8, 30), chartTime(2004, 9, 13), chartTime(2004, 9, 27), chartTime(
2004, 10, 4), chartTime(2004, 10, 11), chartTime(2004, 11, 8), chartTime(2004, 11, 8),
chartTime(2004, 11, 22), chartTime(2004, 11, 22));
# the actual start dates and end dates for the tasks up to now
$actualStartDate = array(chartTime(2004, 8, 16), chartTime(2004, 8, 27), chartTime(2004, 9, 9),
chartTime(2004, 9, 18), chartTime(2004, 9, 22));
$actualEndDate = array(chartTime(2004, 8, 27), chartTime(2004, 9, 9), chartTime(2004, 9, 27),
chartTime(2004, 10, 2), chartTime(2004, 10, 8));
# Create a XYChart object of size 620 x 280 pixels. Set background color to light green (ccffcc)
# with 1 pixel 3D border effect.
$c = new XYChart(620, 280, 0xccffcc, 0x000000, 1);
# Add a title to the chart using 15 points Times Bold Itatic font, with white (ffffff) text on a
# dark green (0x6000) background
$c->addTitle("Multi-Layer Gantt Chart Demo", "Times New Roman Bold Italic", 15, 0xffffff
)->setBackground(0x006000);
# Set the plotarea at (140, 55) and of size 460 x 200 pixels. Use alternative white/grey background.
# Enable both horizontal and vertical grids by setting their colors to grey (c0c0c0). Set vertical
# major grid (represents month boundaries) 2 pixels in width
$c->setPlotArea(140, 55, 460, 200, 0xffffff, 0xeeeeee, LineColor, 0xc0c0c0, 0xc0c0c0)->setGridWidth(
2, 1, 1, 1);
# swap the x and y axes to create a horziontal box-whisker chart
$c->swapXY();
# Set the y-axis scale to be date scale from Aug 16, 2004 to Nov 22, 2004, with ticks every 7 days
# (1 week)
$c->yAxis->setDateScale(chartTime(2004, 8, 16), chartTime(2004, 11, 22), 86400 * 7);
# Add a red (ff0000) dash line to represent the current day
$c->yAxis->addMark(chartTime(2004, 10, 8), $c->dashLineColor(0xff0000, DashLine));
# Set multi-style axis label formatting. Month labels are in Arial Bold font in "mmm d" format.
# Weekly labels just show the day of month and use minor tick (by using '-' as first character of
# format string).
$c->yAxis->setMultiFormat(StartOfMonthFilter(), "<*font=Arial Bold*>{value|mmm d}",
StartOfDayFilter(), "-{value|d}");
# Set the y-axis to shown on the top (right + swapXY = top)
$c->setYAxisOnRight();
# Set the labels on the x axis
$c->xAxis->setLabels($labels);
# Reverse the x-axis scale so that it points downwards.
$c->xAxis->setReverse();
# Set the horizontal ticks and grid lines to be between the bars
$c->xAxis->setTickOffset(0.5);
# Use blue (0000aa) as the color for the planned schedule
$plannedColor = 0x0000aa;
# Use a red hash pattern as the color for the actual dates. The pattern is created as a 4 x 4 bitmap
# defined in memory as an array of colors.
$hashPattern = array(0xffffff, 0xffffff, 0xffffff, 0xff0000, 0xffffff, 0xffffff, 0xff0000, 0xffffff,
0xffffff, 0xff0000, 0xffffff, 0xffffff, 0xff0000, 0xffffff, 0xffffff, 0xffffff);
$actualColor = $c->patternColor($hashPattern, 4);
# Add a box whisker layer to represent the actual dates. We add the actual dates layer first, so it
# will be the top layer.
$actualLayer = $c->addBoxLayer($actualStartDate, $actualEndDate, $actualColor, "Actual");
# Set the bar height to 8 pixels so they will not block the bottom bar
$actualLayer->setDataWidth(8);
# Add a box-whisker layer to represent the planned schedule date
$c->addBoxLayer($startDate, $endDate, $plannedColor, "Planned")->setBorderColor(SameAsMainColor);
# Add a legend box on the top right corner (595, 60) of the plot area with 8 pt Arial Bold font. Use
# a semi-transparent grey (80808080) background.
$b = $c->addLegend(595, 60, false, "Arial Bold", 8);
$b->setAlignment(TopRight);
$b->setBackground(0x80808080, -1, 2);
# Output the chart
$viewer = new WebChartViewer("chart1");
$viewer->setChart($c, SVG);
# Include tool tip for the chart
$viewer->setImageMap($c->getHTMLImageMap("", "",
"title='{xLabel} ({dataSetName}): {top|mmm dd, yyyy} to {bottom|mmm dd, yyyy}'"));
?>
<!DOCTYPE html>
<html>
<head>
<title>Multi-Layer Gantt Chart</title>
<!-- Include ChartDirector Javascript Library to support chart interactions -->
<script type="text/javascript" src="cdjcv.js"></script>
</head>
<body style="margin:5px 0px 0px 5px">
<div style="font:bold 18pt verdana;">
Multi-Layer Gantt Chart
</div>
<hr style="border:solid 1px #000080; background:#000080" />
<div style="font:10pt verdana; margin-bottom:1.5em">
<a href="viewsource.php?file=<?=basename(__FILE__)?>">View Chart Source Code</a>
</div>
<!-- ****** Here is the chart image ****** -->
<?php echo $viewer->renderHTML(); ?>
</body>
</html>
© 2025 Advanced Software Engineering Limited. All rights reserved.
